| |||||||
Approvals of all applications for development shall not be valid until all the following have taken place: | |||||||
a. The Administrative Officer (Planning Board or Board of Adjustment Secretary) shall certify that all conditions of approval have been satisfied.
| |||||||
b. In the case of applications for development for subdivisions, the applicant shall submit two (2) reproducible mylar copies and one (1) linen copy of the plat for signature of the Chairman, Board Engineer and Secretary of the Planning Board or Board of Adjustment. One (1) mylar copy shall be kept by the City Engineer.
| |||||||
c. The applicant shall provide six (6) copies of the plat and attachments: After signature, the Administrative Officer shall have the original and all copies signed and shall return the reproducible original of the plat and attachments to the applicant. One (1) copy shall be retained in the files of the Administrative Officer, two (2) copies shall be retained in the files of the City Engineer, one (1) copy shall be retained in the files of the Construction Official, and one (1) copy to the applicant.
| |||||||
d. After signature and reproduction the Administrative Officer shall return the reproducible original of the plat and attachments to the applicant.
| |||||||

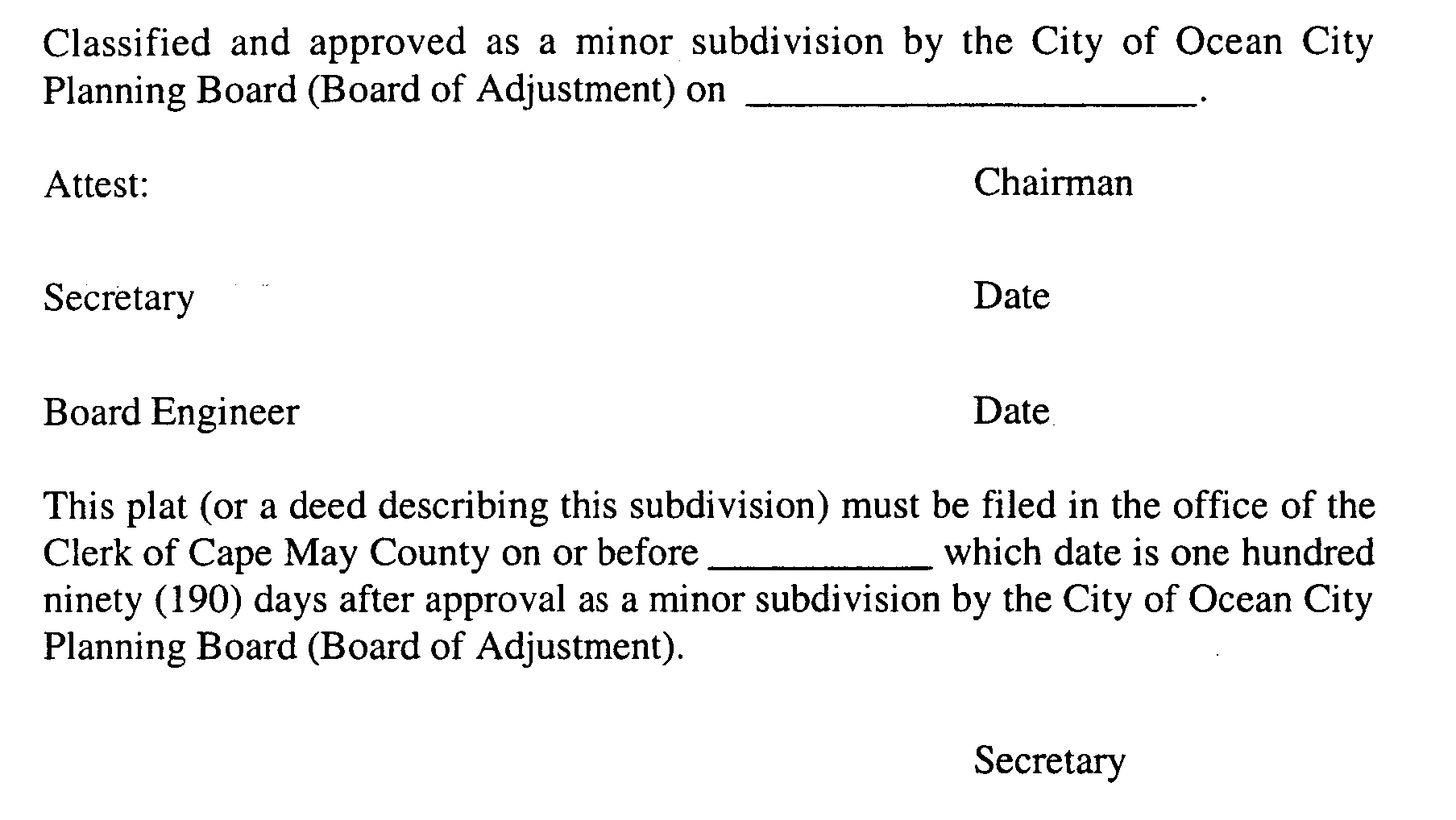

e. For all applications for development that receive minor or final plat approval, the Administrative Officer shall issue a Zoning Permit after the plat has been signed. The date of the Zoning Permit shall be the date upon which the approval of applications for development related to preliminary plats become valid shall be the date on which the plat is signed by the Chairman and Secretary of the Planning Board or Board of Adjustment. However, the period of time for which certain rights are conferred upon the applicant shall commence on the date which the Planning Board or Board of Adjustment granted the approval. (Ord. #99-20, §8)
| |||||||
| |||||||
The Planning Board may, upon specific written request of an applicant, consider and approve or deny requests for waiver of submission requirements or for any of the specific plat detail requirements as set forth in this Article. All such requests by an applicant shall cite the specific requirement by section number and shall state the specific reason for request of waiver. An application which either meets all submission and detail requirements will be considered complete. If a request for waiver is denied, the applicant must provide the required submissions. Such detailed submissions will be reviewed as provided for new applications and all time limits will recommence as for new applications. | |||||||
| |||||||
| |||||||
Prior to issuance of a Certificate of Completeness or scheduling of a minor subdivision for public hearing, the Administrative Officer (Planning Board or Board of Adjustment Secretary) shall determine that the following have been submitted in proper form: | |||||||
a. A Certificate of Title, which may be on the plat (signed by the owner and notarized) or in a letter form, signed by a member of the New Jersey Bar, by a title officer or authorized agent of a title insurance company licensed to do business in the State of New Jersey, which certificate shall confirm that the owner of the premises in question is the owner as shown on the plat.
| |||||||
b. Board Engineer's and City Planner's report.
| |||||||
c. Application for State wetlands approval, where required.
| |||||||
d. Other submittals that may be required by the Board Engineer, Planning Board or Board of Adjustment, or by Federal, State, County or municipal law, including but not limited to a traffic report and EIS.
| |||||||
e. The application for development for a minor subdivision or minor site plan shall include a request for the granting of any variances required.
| |||||||
f. Required application fees as set forth in Article 1400 of this Ordinance.
| |||||||
g. One (1) original and twenty-four (24) copies of a completed application form.
| |||||||
